Fehmarnbelt Fixed Link: Building the 19 km Immersed Tunnel Under the Baltic

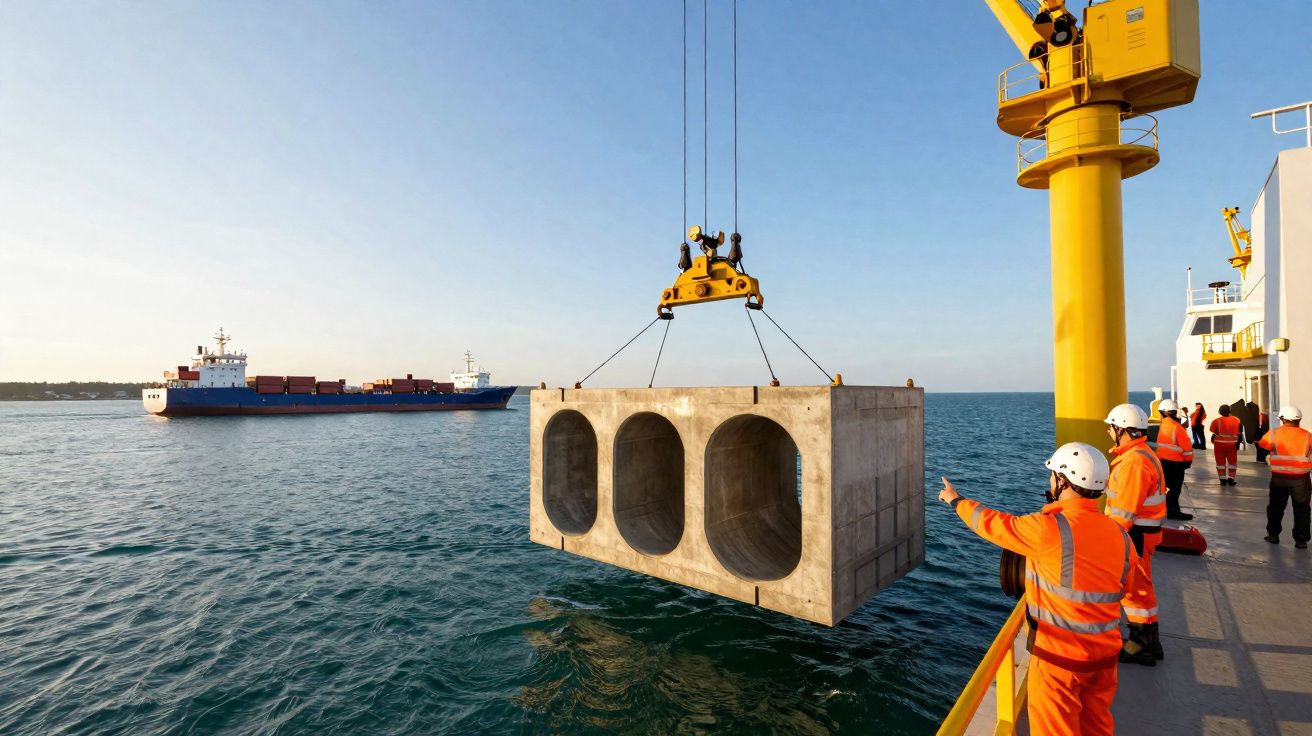

Workers in safety gear guide a large concrete structure suspended by crane over the sea near a cargo ship.

Engineers, captains and welders are steadily putting the groundwork in place for a scheme set to reshape travel in northern Europe-installed one enormous tunnel element at a time.

Fehmarnbelt Fixed Link: a 19 km shortcut under the Baltic

The Fehmarnbelt Fixed Link will run between Rødbyhavn in Denmark and Puttgarden in Germany, using an immersed tunnel that rests on the seabed. When it opens, motorists and rail passengers will be able to cross the strait in minutes, rather than spending close to an hour on the ferry.

Measuring about 18 kilometres end to end, it will rank among the longest immersed road-and-rail tunnels in the world. The layout includes a four-lane motorway and two electrified railway tracks in separate tubes, alongside a service corridor.

The backbone of the entire link is a chain of hollow concrete segments, each as heavy as a small cruise ship.

The elements are produced onshore in a purpose-built factory, then sealed and floated out before being towed by tugboats into the Fehmarnbelt. From there, they are lowered with millimetre accuracy into a prepared trench on the seabed.

The arrival of two maritime giants

A key dependency has shaped the construction timeline for months: the arrival of two huge specialist vessels built to handle the 73,000‑tonne tunnel elements. Without these ships, there is no practical way to position the concrete units precisely on the seabed.

Often likened to “mega-floating cranes” paired with high-precision positioning technology, the vessels have been engineered specifically for this job. They can hold station in wind, waves and current while lowering a vast concrete block tens of metres below the surface.

Each standard tunnel element is roughly 217 metres long, weighs up to 73,000 tonnes, and must be aligned within a few centimetres.

Working in tandem, the ships operate like a tightly choreographed pair: one manages the element’s forward end while the other controls the aft end. Crews use GPS, sonar and laser guidance to match the exact location set by engineers on land.

Why the tunnel needed to “wait” for them

While the Fehmarnbelt site has been moving ahead-dredging along the route, placing protective layers, and completing the dedicated element factory at Rødbyhavn-the most sensitive phase could not begin. Installing the elements had to be held back until the heavy-lift vessels had finished testing and gained certification.

A series of trial operations in calmer waters validated ballast systems, winches, cables and safety procedures. If something failed with a 73,000‑tonne unit suspended beneath the ship, the consequences could be severe for crews, equipment and the marine environment.

Only once these checks were signed off could the vessels sail for the Baltic, where workable weather windows are brief and conditions can shift quickly.

How an immersed tunnel is built, step by step

To see what the vessels will do in practice, it helps to set out the construction sequence in straightforward stages:

  • Excavation: dredgers remove seabed material to form a trench along the chosen alignment, at times reaching around 16 metres deep.
  • Seabed preparation: gravel and crushed rock are placed to create a stable, level base.
  • Element construction: the large concrete units are cast in the factory, then cured and fitted out internally.
  • Float‑out: once sealed, the hollow elements are floated out, behaving like enormous, blunt-ended vessels.
  • Towing and positioning: tugboats, supported by the two heavy-lift ships, tow the element and hold it accurately above the trench.
  • Immersion: ballast water is introduced in a controlled way while winches lower the unit down to the seabed.
  • Connection: divers and remotely operated systems join each new element to the previous one using gaskets and steel interfaces.
  • Backfilling and protection: gravel and rock are placed over the tunnel to protect it from anchors and currents.

The two newly arrived ships take centre stage in the final four stages, where accuracy becomes non-negotiable.

Engineering under pressure

Lowering a 73,000‑tonne element is as much about control as it is about brute force. Currents in the Baltic exert sideways loads, wind pushes on the vessels above, and water pressure increases steadily as the element descends.

On board, crews track a bank of live displays: position, depth, angle, cable tension and the gap to the previously installed section. By adjusting ballast tanks, engineers can shift the element’s centre of gravity while it hangs beneath the hull.

The acceptable margin of error is tiny: alignment must stay within a few centimetres over a length of more than two football pitches.

At the seabed, the unit is guided onto neoprene and rubber seals designed to create a watertight joint. Hydraulic jacks then draw the new element gently towards the one already installed, compressing the seals and securing the connection.

Why size matters for these ships

The ships’ scale is dictated by both the mass and the shape of the elements. A vessel that was undersized would respond more dramatically to waves-pitching and rolling in ways that would make accurate placement almost impossible.

A broad hull and multiple lifting points help spread forces, lowering the risk of overstressing the concrete. The vessels are also long enough to distribute buoyancy so the combined ship-and-element system remains stable as ballast changes throughout immersion.

Transforming travel between Scandinavia and central Europe

The Fehmarnbelt tunnel is frequently labelled a “missing link” between Scandinavia and the wider European network. At present, most travellers depend on ferries or take longer routes via mainland Denmark.

Mode Current typical time Projected time with tunnel
Car (including ferry) Approximately 45 minutes on the ferry, plus waiting and loading Around 10 minutes through the tunnel
Rail (Hamburg–Copenhagen) About 4.5 hours Potentially around 2.5–3 hours

Freight is expected to benefit just as strongly. Goods trains travelling from Sweden and Norway to the continent will no longer be tied to ferry timetables or vulnerable to weather-related cancellations. Logistics planners anticipate more dependable journey times and, potentially, reduced costs.

Economic and environmental stakes

Authorities in Denmark and Germany frame the link as both an economic artery and a climate measure. Moving more long-distance passenger and freight traffic from air and road onto electrified rail could reduce emissions on key routes.

However, the build has also prompted objections from environmental organisations. The Fehmarnbelt strait is home to porpoises, seabirds and sensitive marine habitats. Dredging and construction noise may disrupt wildlife, and altered currents could affect seabed ecosystems.

Project planners argue that early, extensive mitigation-quiet piling techniques, adapted work schedules, and monitoring-can limit long‑term impact.

Independent scientists will continue monitoring biodiversity in the area for years after the opening, assessing whether the promised safeguards deliver in practice.

Why immersed tunnels instead of a bridge?

At an early stage, engineers assessed options including a long cable‑stayed or suspension bridge across the Fehmarnbelt. In the end, they selected an immersed tunnel for several practical reasons:

  • Weather exposure: the Baltic can be windy and icy, and a bridge deck would be more prone to closures.
  • Navigation: an underwater crossing avoids the need for extremely tall pylons and wide navigation spans for major shipping.
  • Visual impact: a submerged connection changes the horizon far less than a vast bridge.
  • Rail constraints: gradients for fast trains are easier to manage in a tunnel where inclines can be controlled.

The trade-off is that immersed tunnels demand complicated marine construction and long-term waterproofing approaches. The joints must remain watertight for decades, and maintenance access is more limited than it would be on a bridge.

Key terms that often confuse people

Project paperwork uses technical language that can be unclear at first glance. Two terms that often cause confusion are “immersed tunnel” and “segment”.

An immersed tunnel is not drilled through rock like the Channel Tunnel. Instead, it is assembled from prefabricated elements that are placed into a dredged trench and then covered. The structure sits on, or just below, the seabed rather than running deep underground.

A tunnel segment, in this setting, is a giant concrete box that is already equipped with internal partitions, ventilation ducting and emergency routes. Much of the electrical and mechanical equipment is installed while the unit is still in the factory-before it ever enters seawater.

Looking ahead: what could this enable next?

The Fehmarnbelt scheme forms part of a broader European corridor plan. Transport strategists envisage overnight freight trains running from Stockholm to Milan without ferry transfers, and daytime passenger services that make rail a stronger alternative to short-haul flights.

The techniques proven here-especially using bespoke vessels to handle extremely heavy elements-could shape later infrastructure projects. Coastal cities dealing with rising sea levels are already exploring whether immersed structures might combine transport links with flood defences or utility tunnels.

Engineers also model less visible risk scenarios in parallel: ship collisions, underwater landslides, unexpected seabed settlement, or major power failures. These assessments inform contingency measures ranging from emergency lighting to cross-passages that allow passengers to move from one tunnel tube to the other.

For future drivers crossing the Baltic in around ten uneventful minutes, most of this complexity will be out of sight. Underneath, a chain of 73,000‑tonne concrete giants-positioned by two equally formidable vessels-will continue its silent work for decades.
